Council planning record

Demolition of existing memorial hall, parish office and storage shed, this will also encompass the hedge line adjacent the building.

BISHOPSTOKE MEMORIAL HALL, RIVERSIDE, BISHOPSTOKE, EASTLEIGH, SO50 6LQ

Decided Grant Conservation Area ConsentReference: C/23/95647Eastleigh Borough Council

Last published check: 3 Oct 2026, 10:23. Check the council record for more recent changes.

Application location

BISHOPSTOKE MEMORIAL HALL, RIVERSIDE, BISHOPSTOKE, EASTLEIGH, SO50 6LQ

This record has no verified map location.

Application summary

Status
Decided Grant Conservation Area Consent
Application type
Conservation area
Received
17 Jul 2023
Validated
5 Sept 2023
Determination deadline
22 Apr 2024
Local authority
Eastleigh Borough Council

Application overview

Demolition of existing memorial hall, parish office and storage shed, this will also encompass the hedge line adjacent the building.

Proposal details

Reference
C/23/95647
Alternative references
12318776
Ward
Bishopstoke Ward
Parish
Bishopstoke CP
Agent
Eastleigh Borough Council (Pearl Tee)

Sign in to view all collected council fields and recorded changes.

Sign in to view collected details

Documents 57 of 57

DocumentPublishedAction
C_23_95647 PL_Final DecisionDecision Notice · PDF22 Apr 2024View
Method Statement and Risk AssessmentSupporting Documents · PDF27 Mar 2024View
Environmental Health final updateConsultation Response · PDF27 Mar 2024View
Bishopstoke Memorial Hall - Photo Survey · PDF27 Mar 2024View
Additional Ecology response 12 3 24 for C 23 95647 BISHOPSTOKE MEMORIAL HALL, RIVERSIDE, BISHOPSTOKEConsultee Response · PDF12 Mar 2024View
Tree Officer revised conConsultation Response · PDF7 Mar 2024View

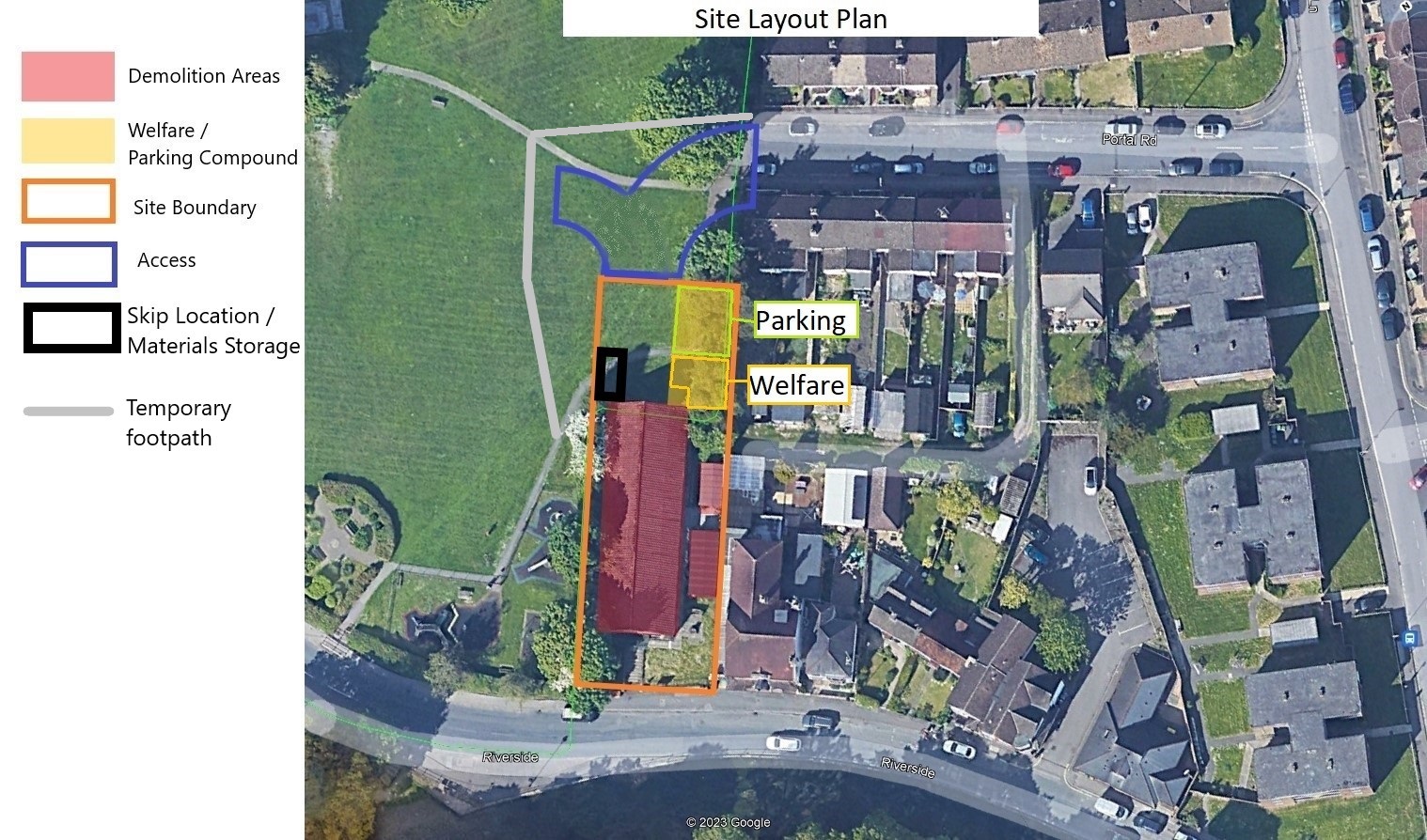

Construction/Demolition & Environmental Management Plan (CEMP)Supporting Documents · PDF7 Mar 2024View

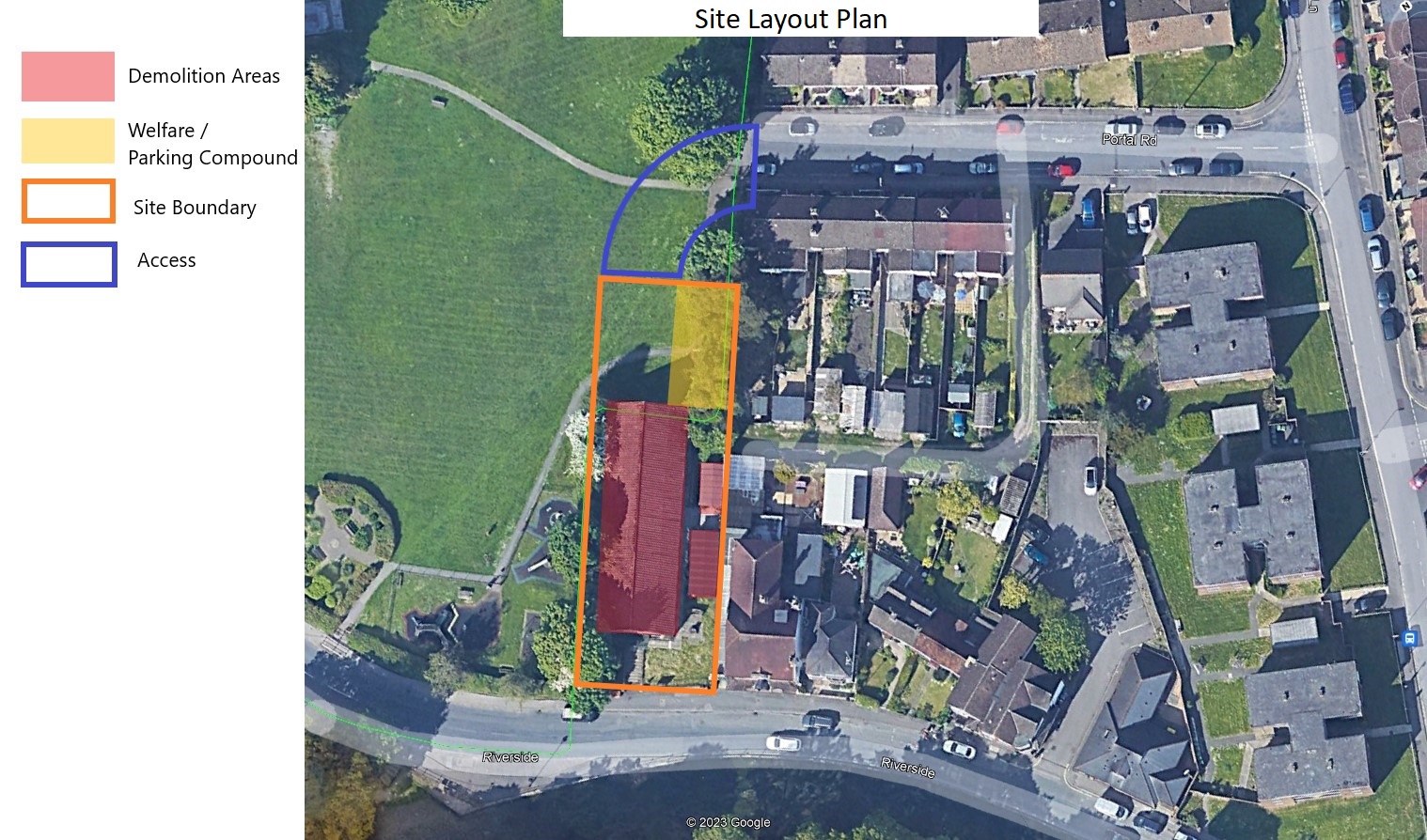

Site Layout PlanSupporting Info · PDF7 Mar 2024View
Hampshire HighwaysConsultation Response · PDF1 Mar 2024View
Survey and Impact Report Area_RedactedTree Info · PDF27 Feb 2024View
SUPERSEDED Construction/Demolition & Environmental Management Plan (CEMP)Supporting Documents · PDF27 Feb 2024View
Tree impact and protection planTree Info · PDF27 Feb 2024View
Hampshire HighwaysConsultation Response · PDF22 Feb 2024View
Natural EnglandConsultation Response · PDF21 Feb 2024View
Additional Ecology response 16 2 24 for C 23 95647 BISHOPSTOKE MEMORIAL HALL, RIVERSIDE, BISHOPSTOKEConsultee Response · PDF16 Feb 2024View
Asbestos Management PlanSupporting Documents · PDF30 Jan 2024View
SUPERSEDED Construction/Demolition & Environmental Management Plan (CEMP)Supporting Documents · PDF30 Jan 2024View
SUPERSEDED Method Statement and Risk AssessmentSupporting Documents · PDF30 Jan 2024View
Construction Phase PlanSupporting Documents · PDF30 Jan 2024View
Hampshire HighwaysConsultation Response · PDF18 Jan 2024View
SUPERSEDED Construction Phase PlanSupporting Documents · PDF18 Jan 2024View
SUPERSEDED Demolition Asbestos Survey_Redacted · PDF9 Jan 2024View
SUPERSEDED Method Statement and Risk AssessmentSupporting Documents · PDF4 Jan 2024View
Demolition Site PlanSupporting Info · PDF4 Jan 2024View
Demolition Traffic Management PlanSupporting Info · PDF4 Jan 2024View
Additional Ecology response 4 1 24 for C 23 95647 BISHOPSTOKE MEMORIAL HALL, RIVERSIDE, BISHOPSTOKEConsultee Response · PDF4 Jan 2024View
Demolition Fire PlanSupporting Info · PDF4 Jan 2024View
SUPERSEDED Construction Phase PlanSupporting Documents · PDF4 Jan 2024View
Planning Application - Bishopstoke Memorial Hall Riverside Bishopstoke SO50 6LQ - C2395647Committee Report · PDF29 Nov 2023View
Environmental Health updateConsultation Response · PDF24 Nov 2023View
Additional Ecology response for C 23 95647 BISHOPSTOKE MEMORIAL HALL, RIVERSIDE, BISHOPSTOKEConsultee Response · PDF23 Nov 2023View
SUPERSEDED Construction/Demolition & Environmental Management Plan (CEMP)Supporting Documents · PDF23 Nov 2023View
Supporting Letter to Planning from ParishSupporting Info · PDF21 Nov 2023View
Hampshire HighwaysConsultation Response · PDF20 Nov 2023View
SUPERSEDED CEMP Site Layout PlanSupporting Info17 Nov 2023View
Bat Surveys & Ecological Update ReportSupporting Documents · PDF17 Nov 2023View
SUPERSEDED Construction & Environmental Management PlanSupporting Documents · PDF17 Nov 2023View
HRA screening letter_Redacted · PDF15 Nov 2023View
Hampshire HighwaysConsultation Response · PDF8 Nov 2023View
Historic EnglandConsultation Response · PDF6 Nov 2023View
SUPERSEDED Site Layout PlanSite Layout Plan31 Oct 2023View
SUPERSEDED Construction & Environmental Management PlanSupporting Documents · PDF31 Oct 2023View
Appendix 2 Refuel and Spill Procedure - CEMPSupporting Documents · PDF31 Oct 2023View
HCC ArchaeologyConsultation Response · PDF13 Oct 2023View
Hampshire HighwaysConsultation Response · PDF26 Sept 2023View
Environmental HealthConsultation Response · PDF18 Sept 2023View
Built Heritage ConsultantConsultation Response · PDF14 Sept 2023View
Ecology response for C 23 95647 BISHOPSTOKE MEMORIAL HALL, RIVERSIDE, BISHOPSTOKEConsultee Response · PDF12 Sept 2023View
Heritage StatementSupporting Documents · PDF8 Sept 2023View
SUPERSEDED BMH Heritage Statement.pdfSupporting Documents · PDF5 Sept 2023View
Structural Survey and Appraisal _RedactedSupporting Documents · PDF27 Jul 2023View
Existing Site PlanSite Layout Plan · PDF17 Jul 2023View
Indicative PlanPlan17 Jul 2023View
Application Form RedactedApplication Form · PDF17 Jul 2023View
SUPERSEDED Initial bat survey report - 07 06 23_RedactedSupporting Documents · PDF17 Jul 2023View

Location PlanLocation Plan · PDF17 Jul 2023View
Pre-Demolition Audit(1.2)Supporting Documents · PDF17 Jul 2023View

Documents open on the council website. Browse council documents if a link has changed.

Application timeline

Council milestones and published deadlines. A deadline passing does not confirm a decision.

  1. Date Received

    Published milestoneCouncil source
  2. Date Valid

    Published milestoneCouncil source
  3. Consultation Period Ends

    Past published deadline

    A published target or deadline. It does not confirm an outcome.

    Council source
  4. Decision Date

    Published milestoneCouncil source
  5. Statutory Decision Date

    Past published deadline

    A published target or deadline. It does not confirm an outcome.

    Council source

Decision & conditions

Grant Conservation Area Consent
C_23_95647 PL_Final Decision
Planning conditions
  1. The demolition hereby permitted shall be implemented in accordance with the following plans numbered: LOC 01 and 180820-1150 Reason: For the avoidance of doubt and in the interests of proper planning.
  2. The demolition hereby permitted shall start no later than three years from the date of this decision. Reason: To comply with Section 91 of the Town and Country Planning Act 1990.
  3. The demolition must accord with the arboricultural report reference “IH/Bishopstoke Memorial Hall, Church Road, Bishopstoke, Eastleigh. SO50 6LQ 5332/Surv/Impact”. No demolition or development related works shall commence until the tree protection measures have been installed as per the tree protection plan reference “5332”. Once installed, no access by vehicles or placement of goods, chemicals, fuels, soil or other materials shall take place within the protected area. Tree protection measures shall be retained in their approved form for the duration of the work and may only be modified subject to written agreement from the LPA. Reason: To retain and protect the existing trees which form an important part of the amenity of the locality.
  4. Works shall be carried out in accordance with the submitted and approved Asbestos Management Plan (11246 AMP 00) produced by Wessex Demolition and Salvage Ltd dated 25/01/20204 and Method Statement and Risk Assessment (11246 Rev2) produced by Wessex Demolition and Salvage Ltd dated 19/03/20204. Reason: To ensure the site works and asbestos is suitably controlled.
  5. A verification report of post-demolition works shall be submitted to and approved in writing by the Local Planning Authority, in accordance with the approved Remediation Strategy included in the Wessex Demolition &Salvage Ltd. ‘Method Statement and Risk Assessment for the asbestos removal, soft strip and Demolition works at Bishopstoke Memorial Hall’, dated 19/03/2024, 11246 Rev2, page 18. The verification report should include: a. verification data of remanent soils after demolition works (sample locations, laboratory results, photographs of the remediation works in progress and once remediation works are completed, etc); b. Certificates demonstrating that imported and/or re-use soils are suitable for the intended purpose (if applicable) and; c. evidence that any excavated soils are appropriate disposed of. Reason: To ensure that risks from contaminated land to future users and neighbours are minimised.
  6. In the event that previously unidentified contamination is found when carrying out the approved development it must be immediately reported to the Local Planning Authority. Work shall then cease until an investigation and risk assessment, and where required a remediation scheme, has been submitted to and approved by the Local Planning Authority. Where a remediation scheme is required by the Local Planning Authority, the development shall not be brought into use until a verification report for the remediation work has been submitted to and approved by the Local Planning Authority. All works shall be undertaken by a competent person in accordance with UK Land contamination risk management (LCRM) national guidance and best practice as outlined in BS10175:2011+A2:2017. Reason: To minimise the risk from land contamination for the safety of the occupiers of nearby properties and potential site users.
  7. The submitted and approved Construction Demolition Environmental Management Plan (referenced CDEMP 05), CDEMP Site Layout Plan (referenced CEMP-LP Rev 3) and Construction Phase Plan (referenced 11246 CPP Rev 3), shall be adhered to in full. Reason: to ensure demolition is handled in an appropriate manner.
  8. The submitted Bat Surveys & Ecological Update Report, referenced Rev 1 17 11 23, shall be adhered to in full, including the Section 5 Interpretation and Evaluation. Reason: To ensure biodiversity enhancement and species protection in accordance with policy DM11 of the Eastleigh Borough Local Plan 2016-2036.
  9. Prior to the removal of the boundary hedgerow, a survey of the hedgerow shall be undertaken to record the plant and animal species present in order to establish its current biodiversity value. Details of this survey shall be submitted to and approved in writing by the Local Planning Authority. Reason: To ensure the site is accurately recorded for the purpose of future biodiversity net gain.
  10. Note to Applicant: Vegetation clearance and demolition shall be undertaken outside the bird nesting season (ie between Sept-end Feb) unless otherwise thoroughly checked by a qualified ecologist. If there are any active nests, a 5 m buffer shall be erected to protect the nest from disturbance until the young have fledged and left the nest.
  11. Note to Applicant: In accordance with paragraph 38 of the National Planning Policy Framework (Dec 2023), Eastleigh Borough Council takes a positive approach to the handling of development proposals so as to achieve, whenever possible, a positive outcome and to ensure all proposals are dealt with in a timely manner.
Related records

No related records were published in this section.

Understand this planning record

All planning guides
  • Understanding planning · 13 min read

    Planning application documents: what to read first

    Understand planning application documents, officer reports and decision notices. Use a reading checklist, document table and worked example to inspect a case.

  • Understanding planning · 13 min read

    Planning application statuses explained

    Understand pending consideration, approved, refused and withdrawn planning applications. Compare status labels and find the documents explaining each outcome.

  • Understanding planning · 13 min read

    Planning permission drawings: how to read plans

    Read planning drawings, floor plans, elevations and sections. Use labelled diagrams, a drawing comparison table and revision checks to understand a proposal.
